Two-Bedroom NYC Gut Renovation: Budget, Timeline, Process

What a Two-Bedroom Gut Renovation Really Takes in NYC: Budget, Timeline, and How We Build It

Buyers usually ask us two questions about a two-bedroom that needs everything redone: what will it cost, and when can we move in? Both answers are easier to give before closing than after, and both depend on decisions that get made long before the first wall comes down.

We are Star Renovations NY, a design-build firm working in Manhattan and Brooklyn, and gut renovations are the core of what we do. The apartment sits empty while we work, which lets us open every wall, replace every system, and finish the home the way it was drawn. Below is how we price a two-bedroom, how long each stage runs, and what happens from the first site visit to the final walkthrough.

Sample board with fabric swatches, tile samples, and a gold handle key on a white surface.
schedule your design CONSULTATION

By providing your phone number, you agree to receive SMS text messages from SRNY. Message and data rates may apply. Message frequency varies. Reply STOP to unsubscribe and HELP for assistance.

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

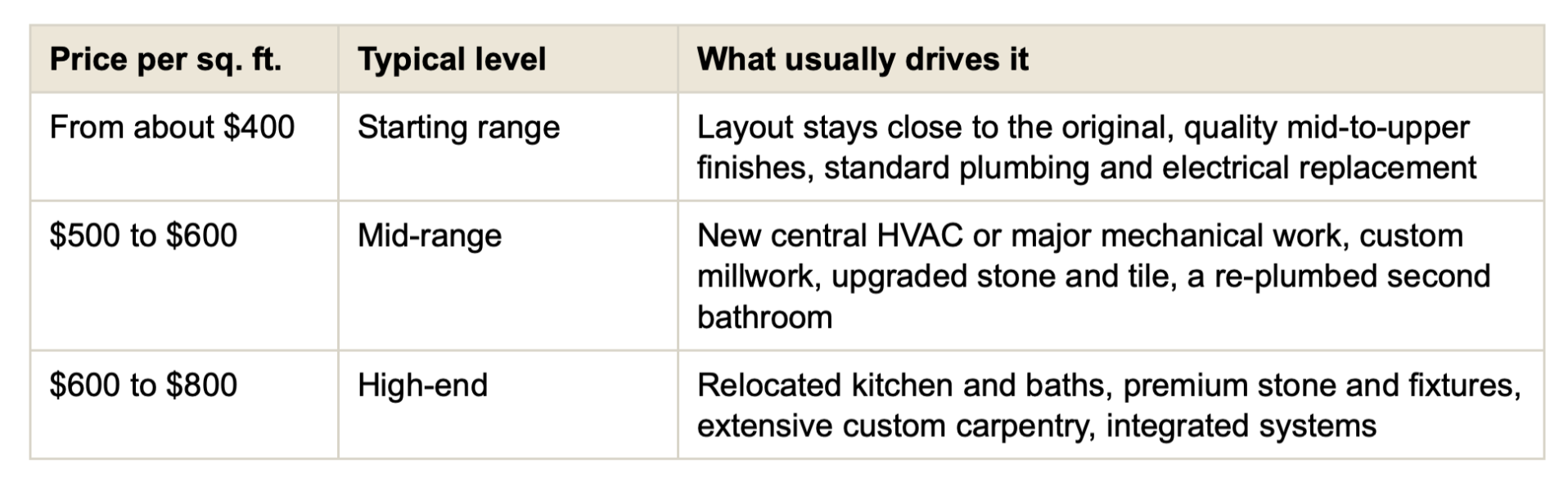

What We Charge: Price Per Square Foot

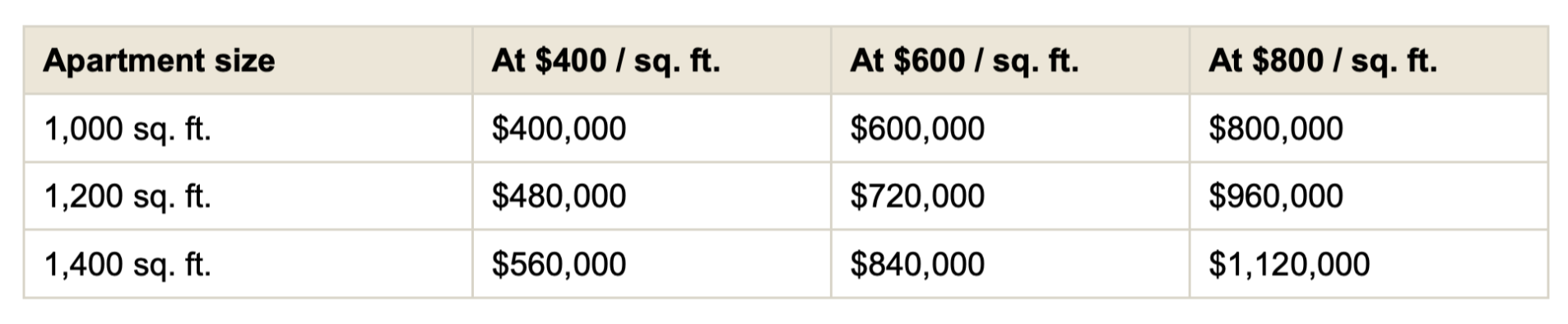

Across our past renovations, a two-bedroom gut renovation starts at roughly $400 per square foot. Projects with high-end finishes, heavier mechanical work, or a fully reconfigured floor plan land between $600 and $800 per square foot. Most two-bedrooms we renovate measure between 1,000 and 1,400 square feet. Our posts on gut renovation costs in NYC and our apartment renovation cost guide go deeper on how those rates were built.

Here is that math applied to common two-bedroom sizes:

Treat these as planning ranges rather than a quote. We price the actual scope once we have drawings and selections. When a budget moves, it usually moves for one of these reasons:

  • Finish level. Slab stone, custom tile, designer fixtures, and specialty flooring are the fastest way to add cost.
  • Mechanical systems. Central HVAC, a service upgrade, or new risers add cost you will never see once the walls close, and they are the upgrades that protect the apartment for decades.
  • Layout changes. Moving a kitchen, enlarging a bath, adding a second full bath, or removing walls means new drawings, new approvals, and more trade work. Our kitchen and bathroom pages show how those decisions play out.
  • Building rules. Freight elevator access, limited work hours, insurance requirements, and board conditions affect how fast a crew can move.
  • What is behind the walls. Older apartments hold surprises that no showing reveals, so we advise a contingency reserve. Our tips on avoiding budget blowouts explain how to size one.

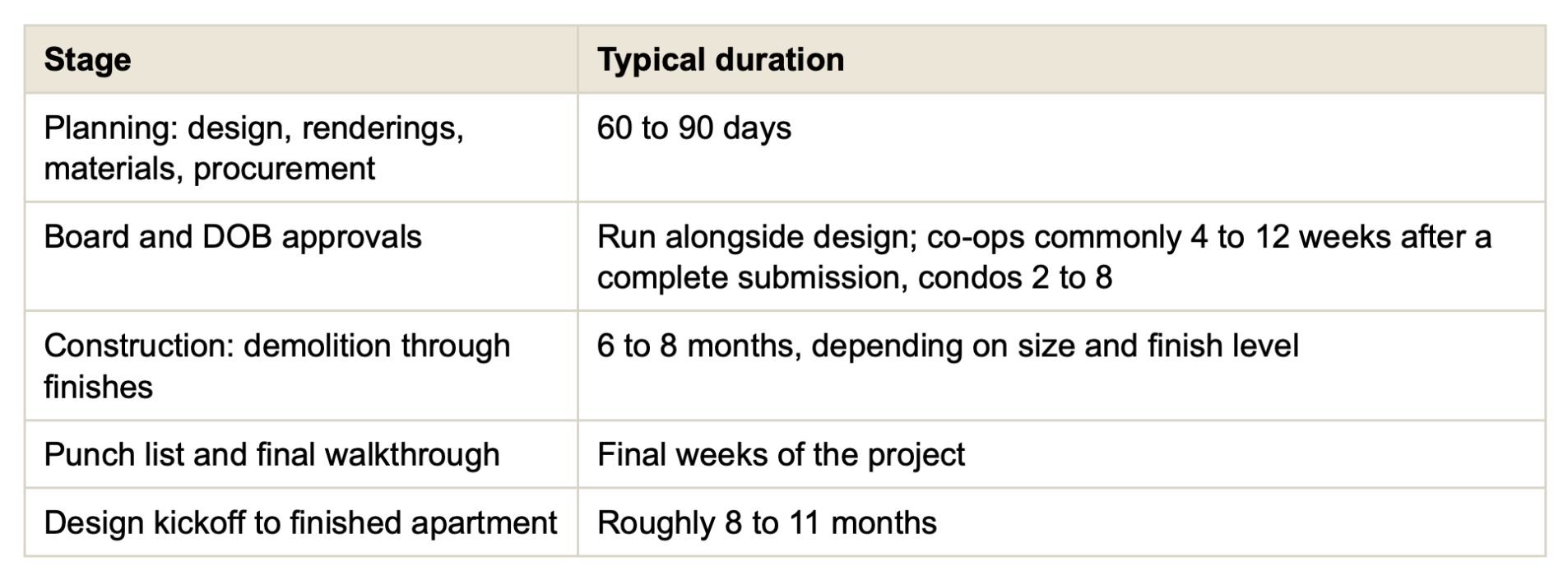

How Long It Takes

A two-bedroom gut renovation has two clocks. Planning runs roughly 60 to 90 days, and construction runs six to eight months, depending on the size of the apartment and the level of finish. From design kickoff to a finished home, that adds up to about eight to eleven months.

Approval times vary by building, and our co-op and condo timeline guide breaks them down. For a broader look at how the stages fit together, read our full-gut renovation timeline and cost breakdown.

Read our latest blog: NYC Full Apartment Renovation Guide: Cost, Timeline and Permits

Sample board with fabric swatches, tile samples, and a gold handle key on a white surface.
schedule your design CONSULTATION

By providing your phone number, you agree to receive SMS text messages from SRNY. Message and data rates may apply. Message frequency varies. Reply STOP to unsubscribe and HELP for assistance.

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

Stage One: Planning, Design, and Approvals

The planning window is where the project is won or lost, so we do several things at once instead of in sequence.

A Site Visit Before Any Design

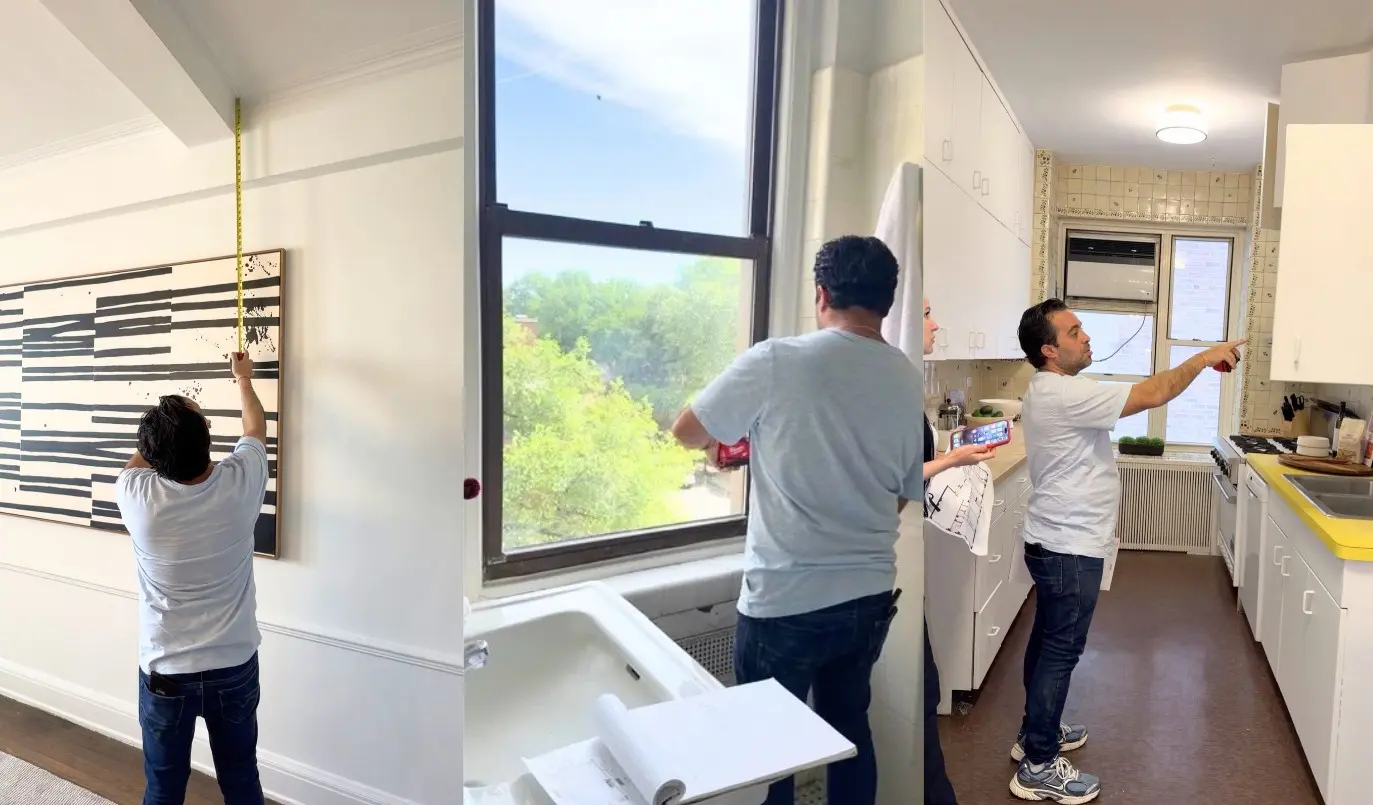

We measure the apartment, locate the plumbing stacks, review electrical capacity, and check ceiling heights and window conditions. The point is to learn what the layout can and cannot do before anyone draws it. Our pre-demolition inspection guide lists what we look for.

Mood Boards and Renderings

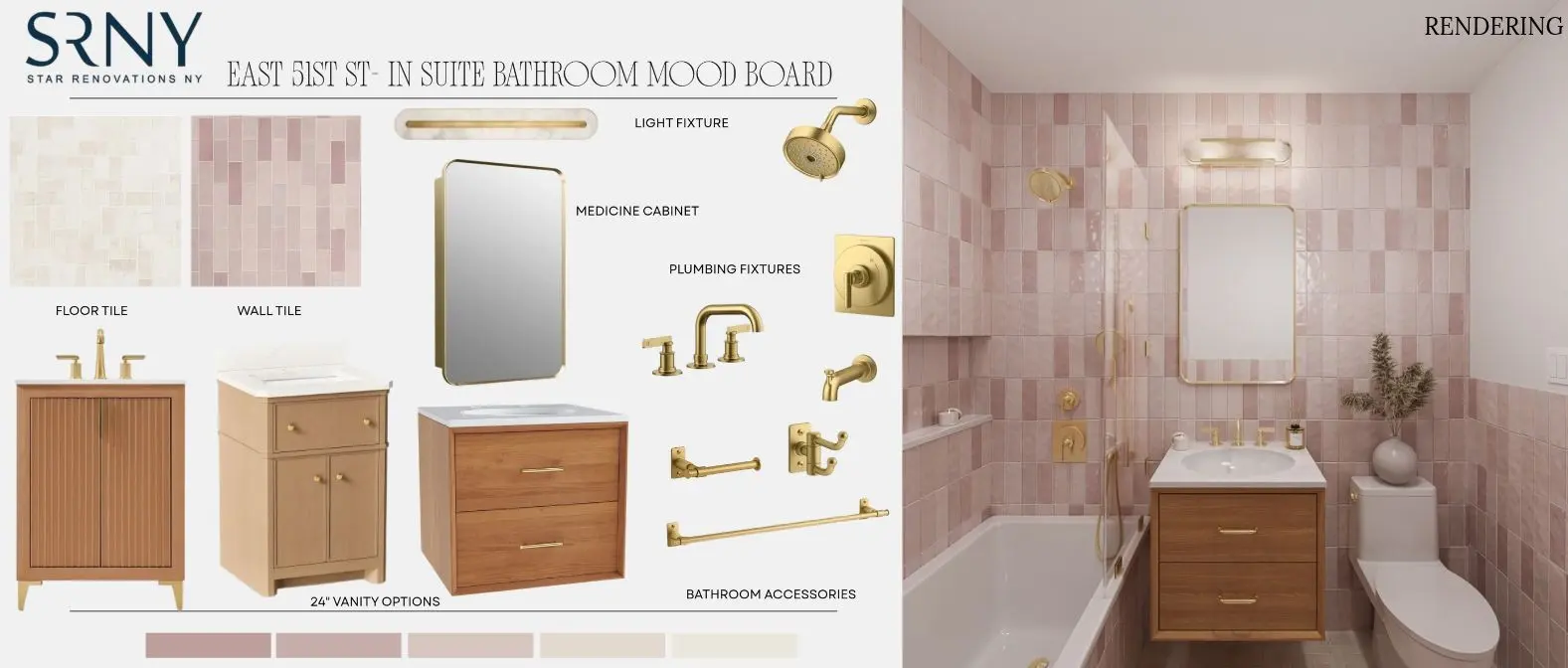

Once we agree on the layout, our designers build mood boards around the materials you respond to: stone, tile, wood tone, metal finish, lighting. Then we turn those choices into 3D renderings, so you see the kitchen, the primary bath, and the living space before anything is ordered. A change on screen costs nothing. The same change after tile is set costs a lot. Construction drawings follow, and they also serve as the basis for board and city submissions.

Permits and Building Approvals

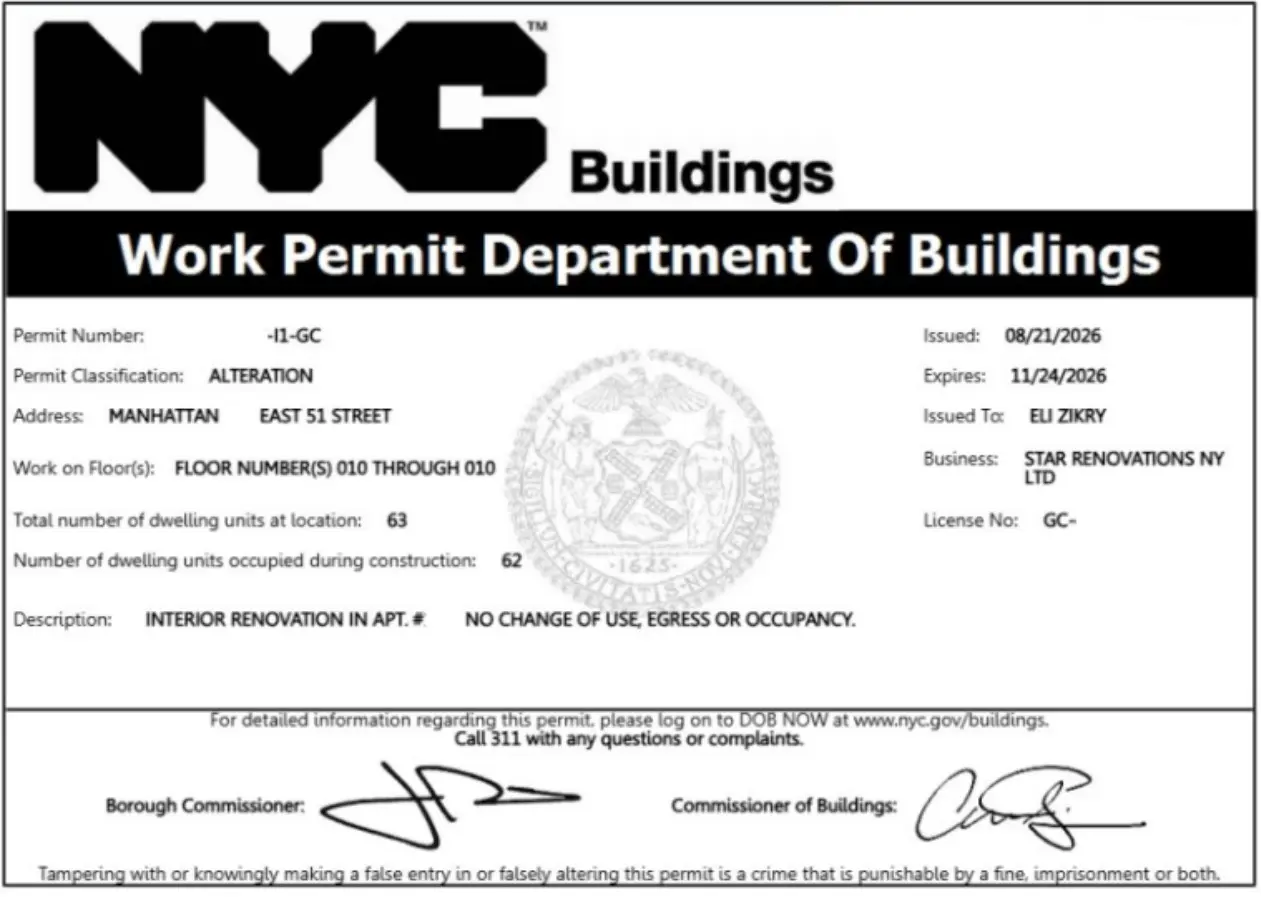

We assemble the approval package, guide the alteration agreement through building management, coordinate insurance and work-hour requirements, and file with the Department of Buildings when the scope calls for it. Our co-op renovation team presents to boards and answers revision requests directly.

The city sets the baseline. The DOB states that most construction in New York City needs approval and permits, and its page on alteration project requirements explains who files what. For buildings constructed before 1978, the EPA’s lead-safe work rule applies to demolition, and we build it into the schedule from day one.

Ordering Materials Early

We order during planning because lead times, not labor, usually decide how long a renovation takes. Cabinetry, appliances, and stone carry the longest and least forgiving waits, as our post on kitchen remodel lead times and backorders shows. This is why roughly 55 percent of the contract is invoiced before demolition wraps up. Those early payments cover drawings, approvals, and materials already on order when our crew arrives. Our milestone payment guide lays out the whole schedule.

Stage Two: Construction, From Demolition to Move-In

Construction is the six-to-eight-month stretch. A dedicated project manager runs the site, and you can follow daily progress and payments in BuilderTrend from anywhere.

Demolition

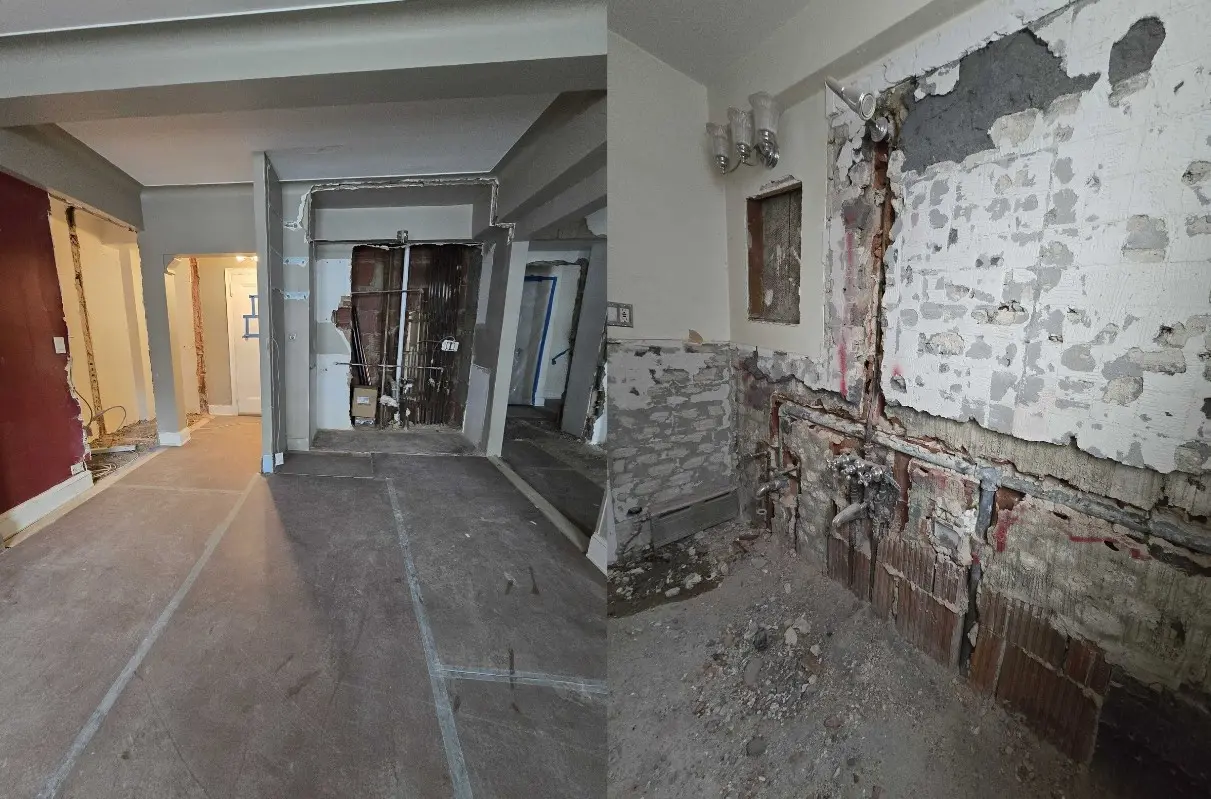

We protect elevators, hallways, and common areas, then take the apartment down to the studs, and to the slab where the design requires it. Debris leaves on your building’s schedule, which usually means reserved freight elevator time. Demolition is also when hidden conditions appear, which is why the contingency matters.

Carpentry and Framing

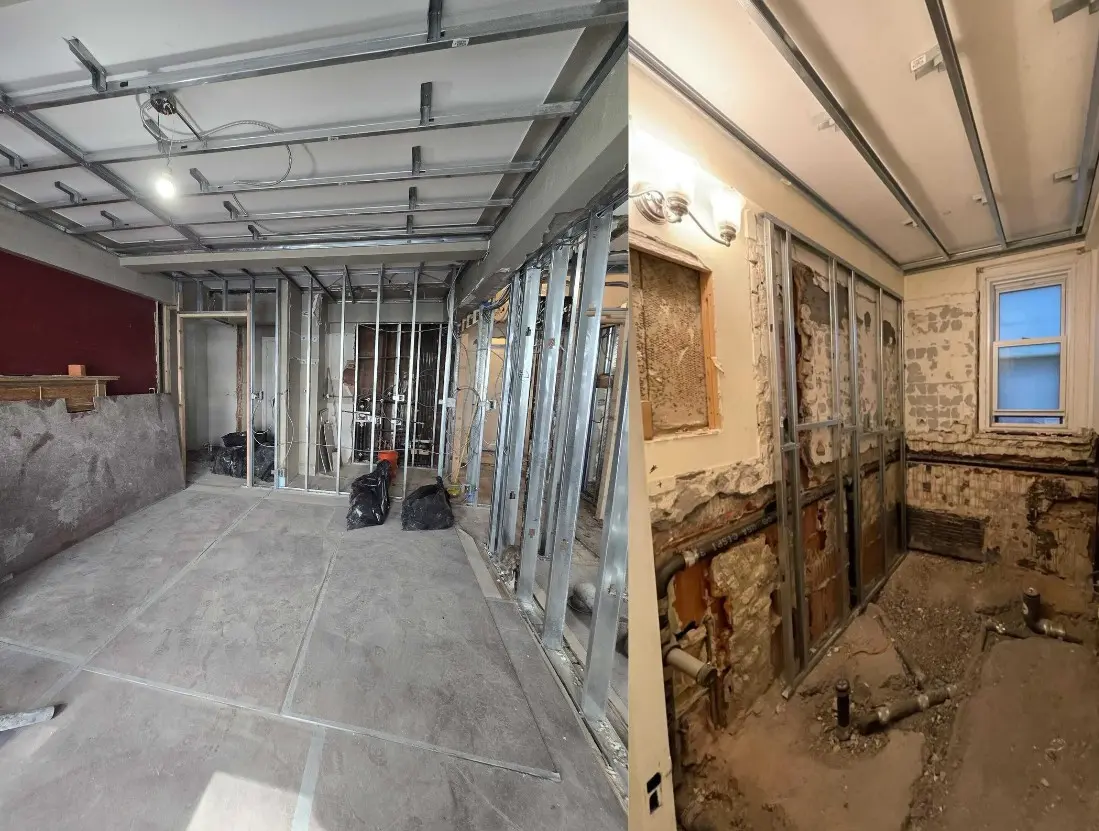

New partitions, ceilings, and soffits go up, with blocking set in the walls for wall-hung fixtures and millwork. Any relocated kitchen or bath gets framed here. We check every dimension against the drawings before it is covered.

Plumbing

New supply and drain lines replace the old ones, fixtures are relocated where the plan calls for it, and bathrooms are built within the building’s wet-over-dry rules. Waterproofing and pressure testing come before any tile.

Electrical

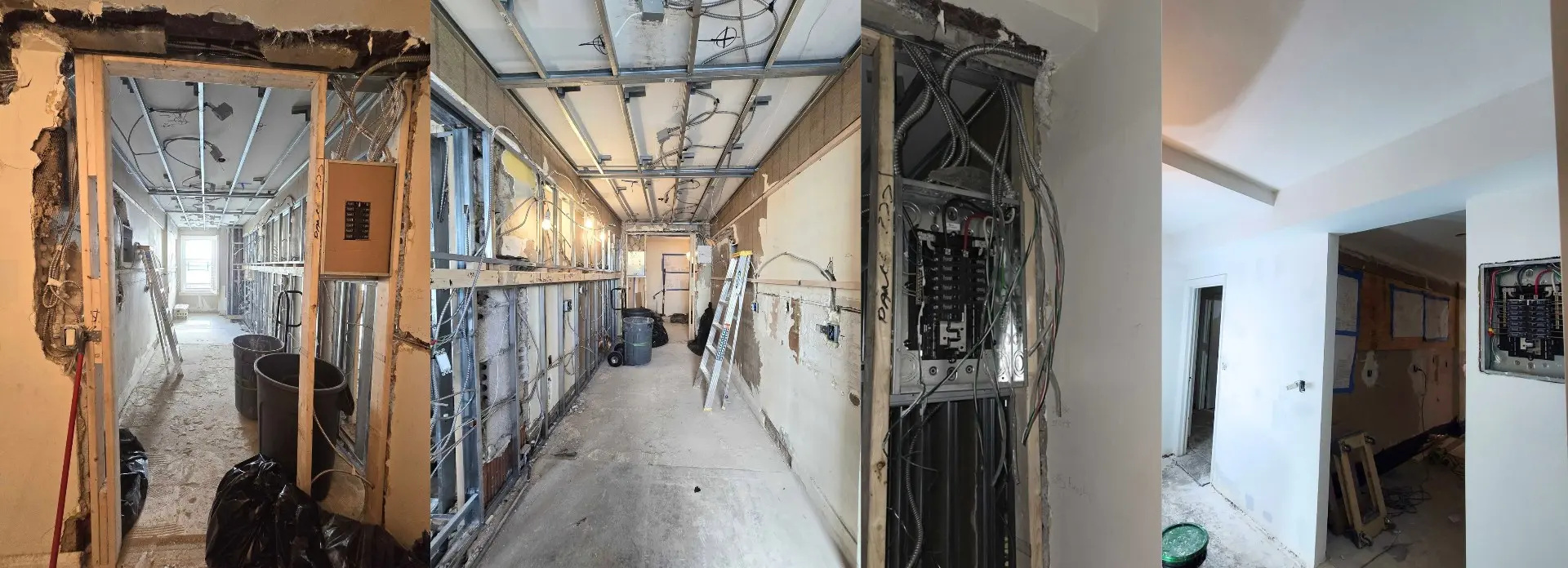

We upgrade service and panels as needed, run new circuits sized for a modern kitchen and home office, lay out lighting and dimming, and pull low-voltage wiring. Rough plumbing and electrical are inspected before the walls close.

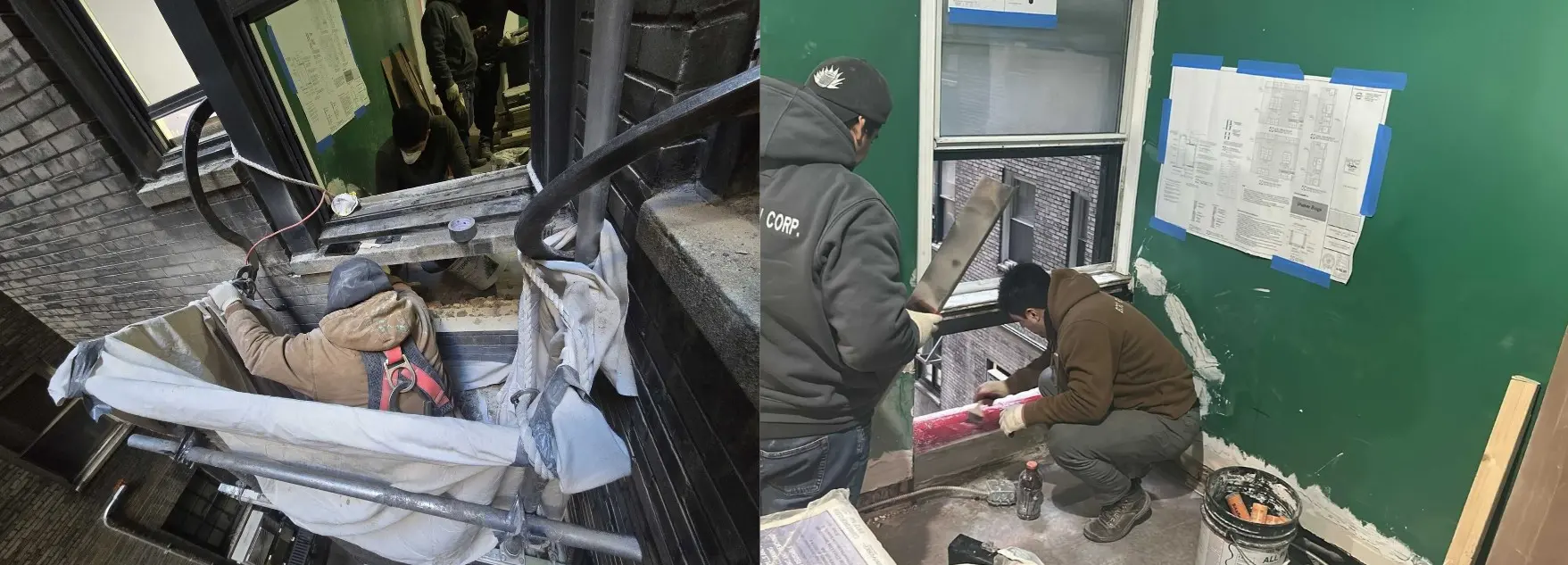

HVAC

A gut renovation is the cleanest moment to add ducted central air, because the ceilings are open and the layout is still flexible. We coordinate the system with the design so diffusers land where they look right. Our comparison of central HVAC and window AC explains why we recommend it.

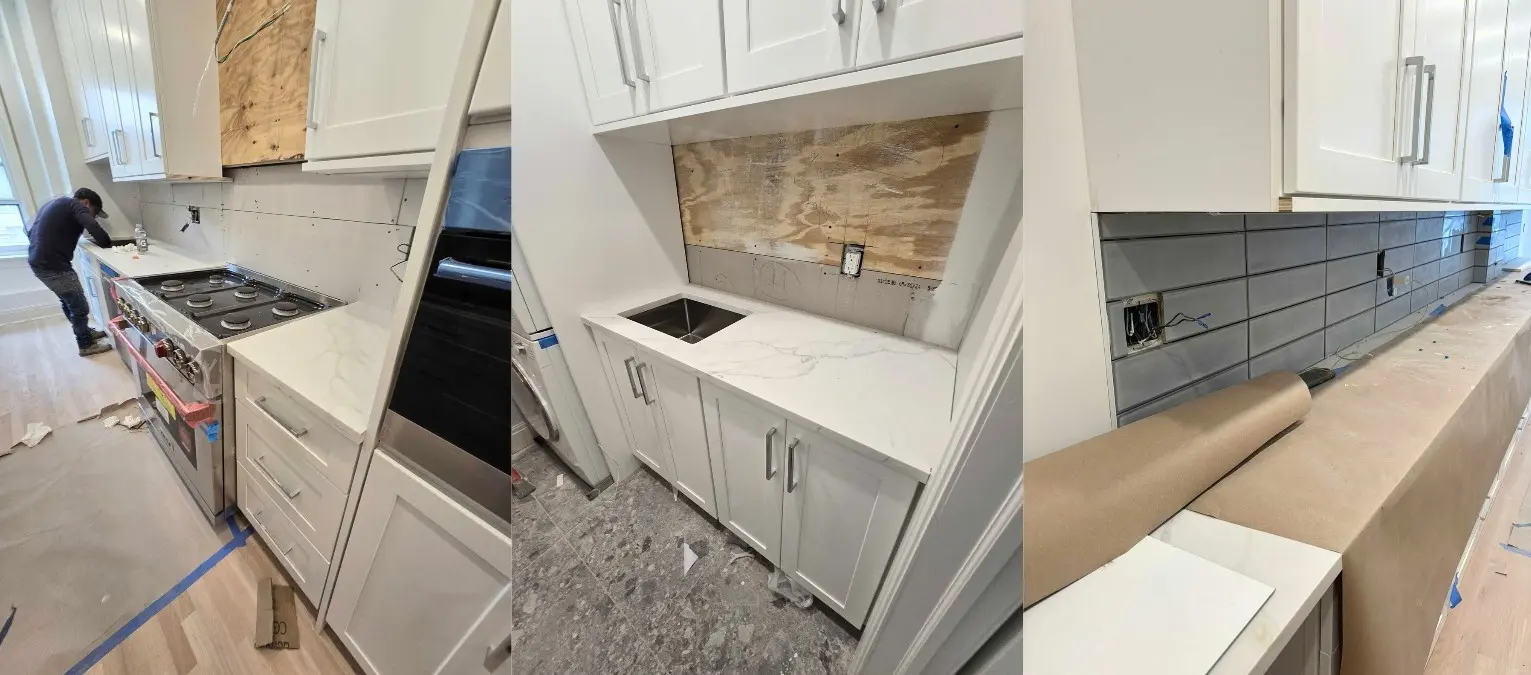

Drywall, Tile, and Stone

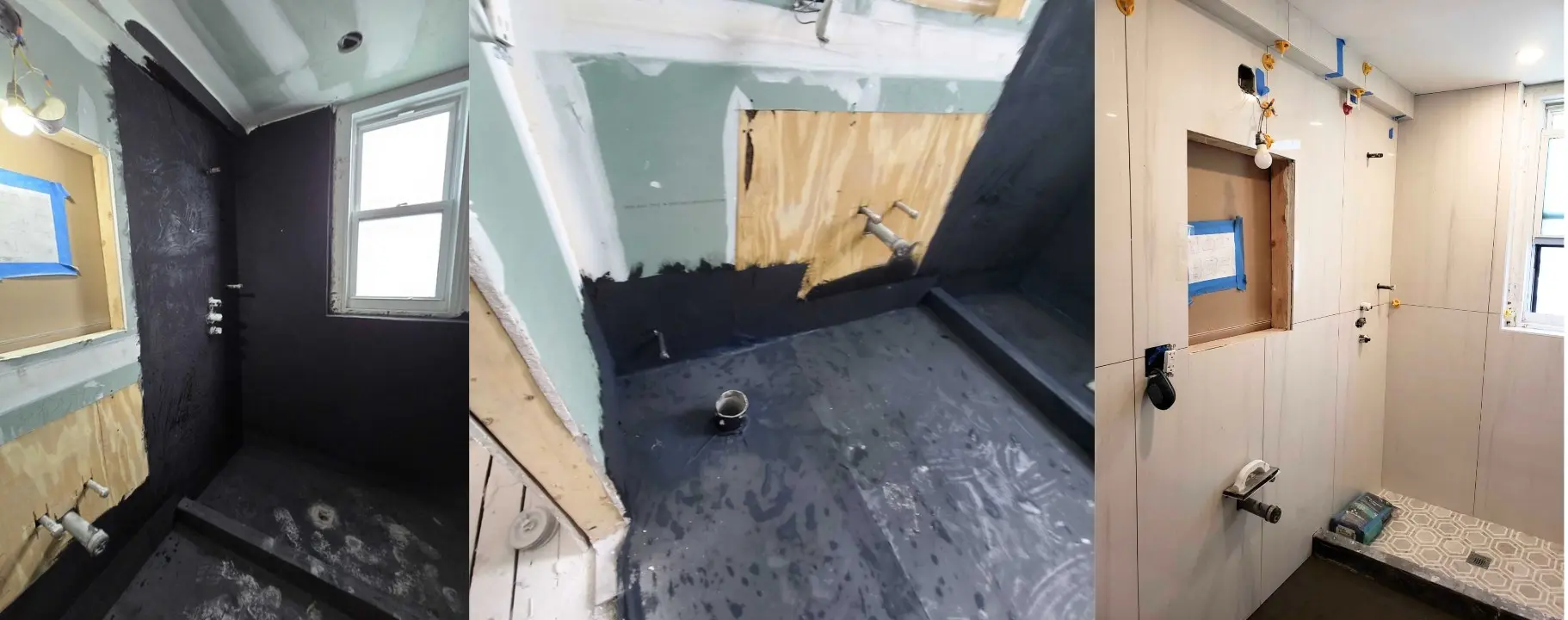

After inspections pass, walls and ceilings are closed and finished smooth. Tile and stone go into the bathrooms and kitchen, and countertops are templated once the cabinets are set, so the fit is exact.

Custom Carpentry

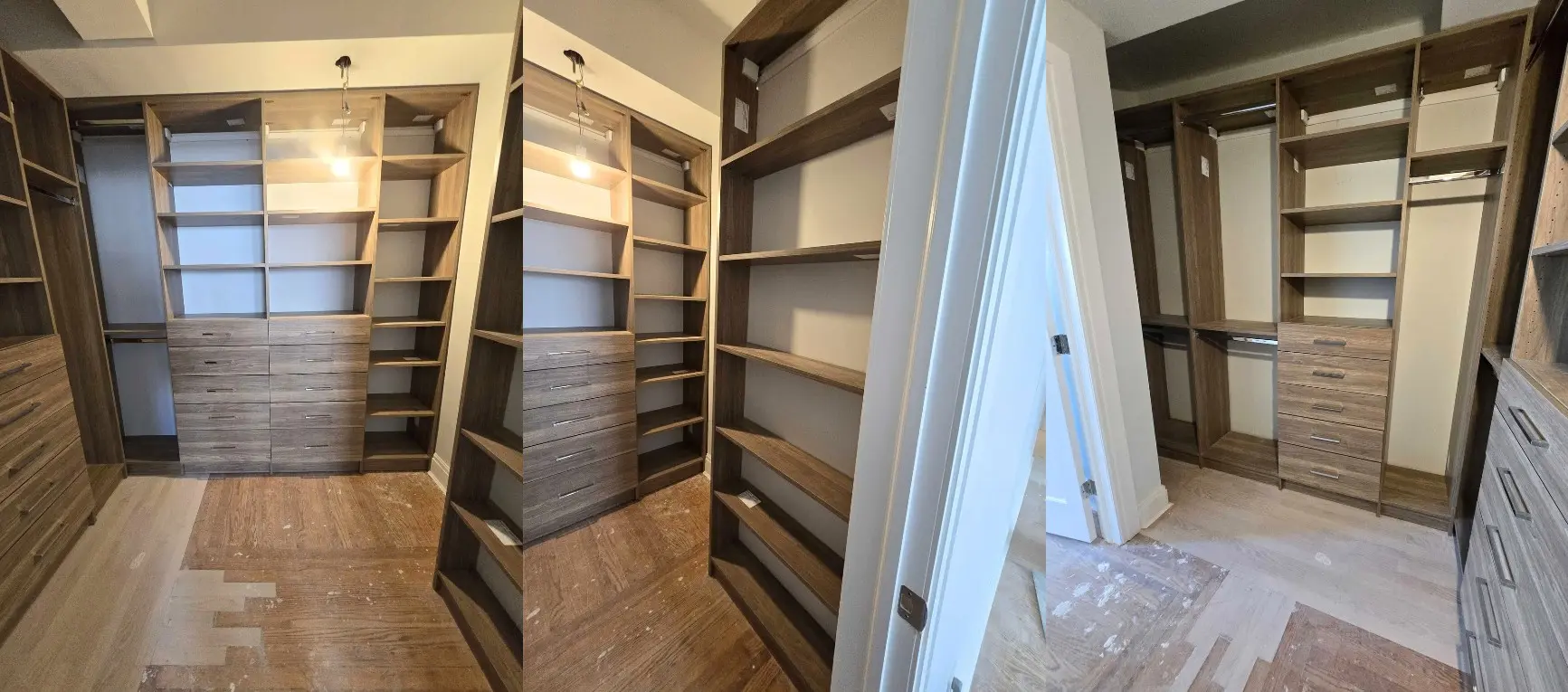

Built-in closets, wall units, doors, trim, and kitchen cabinetry go in next. Custom millwork is where a two-bedroom gains the most storage and character, and our post on luxury millwork ideas shows examples.

Finishes and Handover

Floors are installed and finished, walls painted, and lighting, fixtures, hardware, and appliances installed. We then walk the apartment with you, list every remaining item, and close each one out. You receive warranty documentation and a final cleaning before you move in.

If You Have Not Closed Yet

You do not need the keys to start. Floor plan review, building document research, budget ranges, and early design selections can all happen while you are under contract, which puts construction closer to the day you take possession. A pre-closing walkthrough with our team is the most valuable hour a buyer can spend on a renovation project, and our take on move-in ready versus fixer-upper apartments can help you weigh the tradeoff. If you are closing this fall, leave some room around the year-end holidays, when board reviews and supplier schedules tend to slow.

Client perspective: Jason Z. planned to renovate only the kitchen in his Upper West Side co-op. After seeing our quality, he added new doors and moulding, lighting, built-in cabinetry, a bathroom refresh, and refinished floors. He says our team handled the difficult board approval, permits, and paperwork, finished ahead of schedule, and kept him informed through BuilderTrend. Read more client stories on our reviews page.

Sample board with fabric swatches, tile samples, and a gold handle key on a white surface.
schedule your design CONSULTATION

By providing your phone number, you agree to receive SMS text messages from SRNY. Message and data rates may apply. Message frequency varies. Reply STOP to unsubscribe and HELP for assistance.

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

Two-Bedroom Gut Renovation Q&A

How much does a two-bedroom gut renovation cost in NYC?

Our pricing starts around $400 per square foot and climbs to $600 to $800 per square foot with premium finishes, heavier mechanical work, or a full reconfiguration. For a 1,200-square-foot apartment, that is roughly $480,000 to $960,000. Send us the floor plan and we can narrow it.

How long does the whole process take?

Planning takes 60 to 90 days and construction takes six to eight months, so most projects run eight to eleven months from design kickoff to finished apartment. Board review times can add to that.

Can we start before closing?

Yes. Floor plan review, budget ranges, building document research, and early design work do not require ownership. Our homebuyer guide covers what to weigh before you commit to a renovation project.

Do we need board approval and permits?

In a co-op or condo you need an approved alteration agreement, and the scope often requires Department of Buildings filings as well. We prepare the package, present it, and handle revisions. See our approval package guide for what goes into it.

Do we have to move out?

Yes. We do full gut renovations with the apartment vacant, which keeps crews safe and the schedule predictable.

Why is so much of the contract paid before demolition ends?

Materials drive the schedule. About 55 percent of the contract is invoiced before demolition concludes, and it funds drawings, approvals, and the cabinetry, stone, and fixtures we order early. The milestone payment guide has the details.

What pushes a project from $400 toward $800 per square foot?

Finish level, mechanical work such as central HVAC or new risers, and how much of the layout changes. Keeping the layout with quality mid-range finishes sits near the bottom. Relocating the kitchen and baths with premium stone and custom carpentry sits near the top.

How is design-build different from hiring an architect and a contractor?

One team owns design, approvals, procurement, and construction, so you have one budget and one point of accountability. We compare the two models in architect versus design-build firm.

Talk to Us About Your Two-Bedroom

Star Renovations NY has earned a Best of Houzz Service award every year from 2021 through 2026, and our team handles design, approvals, materials, and construction under one roof. If you are under contract on a two-bedroom, or already own one, send us the floor plan and we will put a realistic budget and timeline in front of you. You can see finished work in our project gallery first.

Schedule your complimentary design consultation

Call: (718) 785-9402

Email: info@srny.nyc

Online: Fill out our contact form and we will follow up directly.

Star Renovations NY, 132 32nd St, Brooklyn, NY 11232. Serving Manhattan and Brooklyn.

Request a consultation
