Manhattan Kitchen Remodel Lead Times and Backorders

Manhattan Kitchen Remodel Lead Times and Backorders
Kitchen remodeling in Manhattan, NYC is about more than selecting a beautiful slab or the perfect range. The real test is orchestrating every detail so materials arrive at your apartment on time, in the right order, without derailing the schedule. One missed lead time on cabinetry or a backordered panelready refrigerator can push a highend project back by weeks and trigger a chain of issues with your building and contractors.
In Manhattan, delays cost more than lost time. Limited building access, elevator reservations, co-op boards, and a packed summer calendar mean every slip in procurement hits harder here than almost anywhere else. Below, we walk through how we sequence cabinetry, appliances, and stone on our own kitchen remodeling projects, what lead times and submittals really mean for your timeline, and how our procurement planning keeps a Manhattan kitchen remodel on track from the very first design meeting.

Why Manhattan Kitchen Timelines Derail
Renovating a kitchen in Manhattan is nothing like working in a single-family home with driveway access and a garage full of on-site storage. Every project we run has to comply with a building’s house rules as much as it does with the design itself. We see this firsthand on nearly every Manhattan co-op gut renovation we manage.
Read our latest blog on how to “Plan A Manhattan Co-op Gut Renovation the Smart Way”
Some of the constraints we plan around on day one include:
- Strict building work hours, shutdown dates, and noise rules
- Limited or timed access to service elevators
- No on-site storage for early deliveries or surplus materials
- Vendor and trade schedules that book up quickly, especially in summer
When a critical item arrives late, the impact rarely stays contained to that one item. A missing appliance or a delayed stone slab can:
- Delay inspections that require full installation
- Force electricians, plumbers, and installers to reschedule
- Trigger fees or lost deposits for elevator bookings and access windows
In our experience, cabinetry, appliances, and stone are almost always the three items with the longest and least flexible lead times. If they aren’t selected and ordered early, the timeline starts slipping before a single wall comes down. Locking these in early is how we protect your completion date and keep the renovation feeling smooth and predictable rather than reactive.

Lead Times, Backorders, and Submittals, Explained
These three factors quietly drive every Manhattan kitchen remodel we take on. Understanding them, and having a team actively managing them on your behalf, is the difference between a calm renovation and a stalled one.
Lead times are the weeks between placing an order and the item being ready to ship. For a high-end kitchen, that typically includes:
- Factory production for custom, semi-custom, or imported cabinetry
- Special-order or panel-ready appliances from specific lines
- Stone slab procurement and fabrication, including custom edge and finish details
Backorders happen when a manufacturer can’t meet demand. A range, dishwasher, or hardware finish that unexpectedly goes on backorder can push a schedule by weeks or months if no one is actively monitoring it and lining up alternates. This is one of the most common surprises we catch before it ever reaches our clients.
Submittals are the technical approvals that have to be completed before fabrication starts. They typically include:
- Cabinet shop drawings with exact dimensions and interior accessories
- Appliance specification sheets for clearances, electrical, and ventilation
- Stone layouts, edge profiles, and finish approvals

Nothing moves into production until these submittals are reviewed and approved. When they sit unanswered in an inbox, time slips away quietly, and a project that should be moving forward starts to feel stalled. We’ve walked plenty of homeowners through exactly this kind of stuck renovation.
Read our latest blog in our guide on how to Audit Your NYC Renovation and Choose Full-Service Help
How Star Renovations NY Protects Your Timeline
A professional design-build team makes sure these details never become your full-time job. On every Manhattan kitchen remodel, our team:
- Tracks vendor lead times and backorder risks across all key items
- Confirms your building’s requirements before anything is ordered
- Sequences submittals so they move quickly instead of waiting on answers
- Coordinates all trades so installation aligns with actual delivery dates
- Logs every milestone in BuilderTrend, so you can see real-time progress instead of guessing
You get clear milestone dates, proactive updates, and a single, dedicated project manager as your point of contact, instead of juggling multiple showrooms, contractors, and email threads on your own. It’s part of why we’ve been recognized with Houzz’s Best of Service award every year since 2021, and why clients like Jason Z. tell us they were “so glad we chose Star Renovations NY,” as you can read in his full review on our testimonials page.
Curious how we’d manage your Manhattan kitchen remodel from concept through completion? Request a consultation with Star Renovations NY.

Building a Realistic Procurement Schedule That Works
A strong procurement plan begins well before demolition day. For a typical Manhattan apartment, condo, or brownstone, especially when you want work to start in summer, our team works backward from your ideal completion date.
The same approach we outline in our latest blog Manhattan kitchen renovation rules, permits, and costs.
Here is the roadmap we follow on most projects:
8 to 12 Weeks Before Demolition
- Finalize kitchen layout and design details
- Confirm cabinet line, door style, finishes, and interior accessories
- Lock in appliance models and any panel-ready details
- Select your preferred stone type and general color direction
- Submit plans to your building and, if needed, the Department of Buildings
6 to 10 Weeks Before Demolition
- Release cabinet orders based on confirmed lead times
- Place appliance orders and verify backorder risks or alternates
- Reserve tentative slab holds at the stone yard where possible
- Begin detailed submittals: cabinet drawings, appliance specs, stone layouts
4 to 6 Weeks Before Demolition
- Confirm delivery windows with all key vendors
- Coordinate storage plans if your building can’t accept early deliveries
- Lock in elevator reservations and access details with your building
- Align trade schedules with the planned arrival of cabinetry and appliances
On every project, we start with your target completion date, maybe you want to be hosting guests in your new kitchen by a specific evening, and reverse-engineer every step that has to happen before then: vendor lead times, co-op reviews, permit timing, and elevator bookings, all mapped out together. If your building also has pre-war infrastructure to navigate, our pre-war co-op kitchen renovation guide covers the additional constraints we plan around.
When your calendar is built this way, you can see exactly how a decision today affects your move-in date tomorrow. There are fewer surprises, fewer gaps in work, and a far smoother path from design sign-off to your first evening in a fully finished kitchen.
Cabinetry, Appliances, and Stone: Sequencing for a Seamless Result

In a high-end Manhattan kitchen, these three categories drive almost every other decision. We treat the order as non-negotiable, because it protects both your schedule and your finish quality. We go into more design detail on this in our luxury Manhattan kitchen remodel planning guide, but here’s the short version of how we sequence it on every project:
Cabinetry often has the longest lead time. To keep your project moving, we:
- Finalize door style, finish, and interior accessories early
- Confirm every measurement and appliance opening in detailed shop drawings
- Secure a production slot so cabinets are ready when the space is prepared
Appliances get locked down before cabinetry is drawn. We:
- Select exact models so cabinet sizes are based on precise dimensions
- Confirm ventilation, power, and gas requirements for trades and inspectors
- Coordinate panel-ready requirements so panels and hardware arrive together

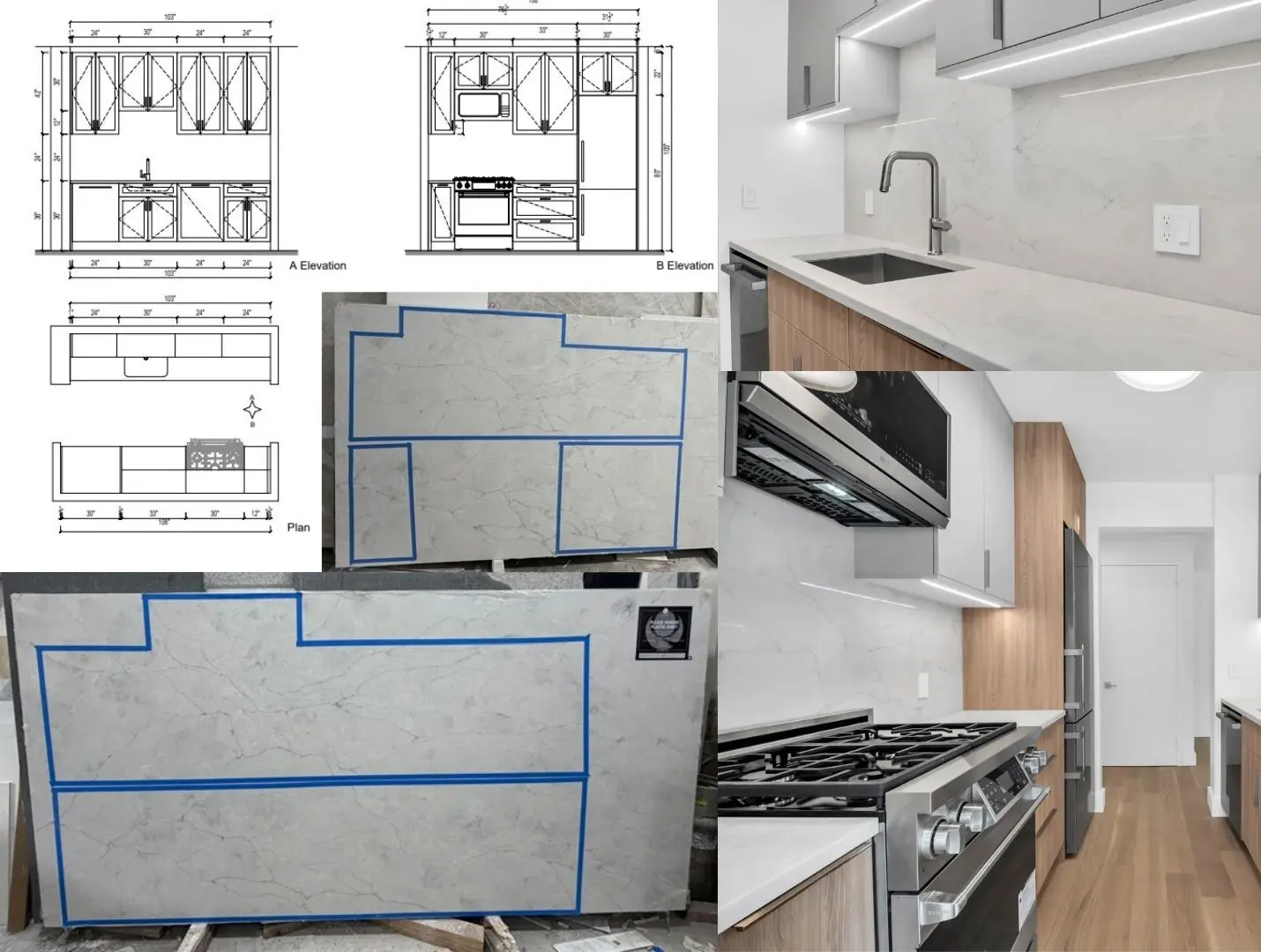

Stone follows cabinetry and appliance decisions, so nothing changes after the slabs are chosen. We:
- Select slabs, finishes, and edge profiles that complement the final cabinet design
- Schedule templating once cabinets are installed, leveled, and secured
- Plan installation to align with appliance and plumbing schedules

This disciplined sequencing minimizes rework and protects the integrity of your finishes. Correct appliance specifications prevent on-site cabinet modifications. Accurate cabinet layouts make stone templating fast and precise. Every piece fits as intended, creating a cohesive, luxury kitchen that feels effortless, because all the friction was resolved long before your installers ever showed up.
White-Glove Management for High-End Manhattan Kitchens
Behind every calm, on-time kitchen remodel in Manhattan is a team managing countless details on your behalf. At Star Renovations NY, we approach each project as a fully managed, white-glove experience focused on clarity, communication, and comfort, the same standard our clients describe in their reviews on our testimonials page.
That includes:
- A dedicated project manager as your single point of contact
- Curated vendor partners who understand New York City buildings
- Thorough documentation so the superintendent, doormen, and trades are aligned
- Proactive schedule management to avoid last-minute surprises
- Careful protection of your home and common areas throughout construction

We handle permit filings, submittals, approvals, logistics, and scheduling with your building, so you receive clear, concise updates and streamlined decision points instead of daily issues to resolve. All of the complexity stays behind the scenes, where it belongs. If you’d like a closer look at how this plays out for a full apartment, not just the kitchen, our full-service renovation guide walks through what that level of oversight looks like across an entire project.
The result is a guided, stress-reduced renovation process and a finished kitchen that reflects high-end craftsmanship, refined materials, and meticulous attention to detail, the kind of project we’re proud to put our name on.
